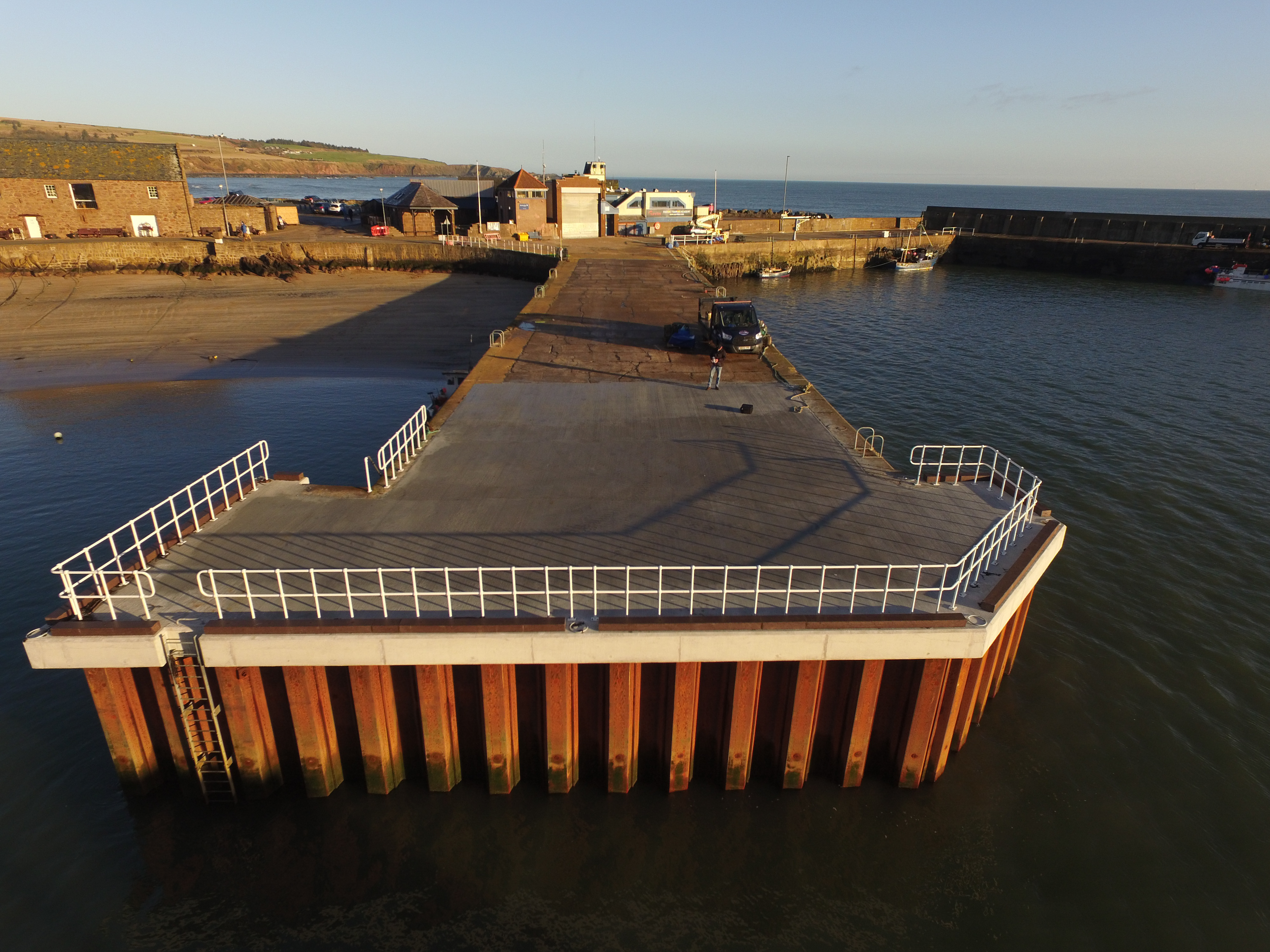

Breathing New Life into Stonehaven Harbour’s Aging Pier Infrastructure

To revive Stonehaven Harbour’s aging piers, TMS Maritime Ltd and DYWIDAG collaborated to deliver an innovative and efficient solution that ensured the piers’ long-term stability and sustainability, completing the project ahead of schedule and under budget.

Context

Stonehaven Harbour in Aberdeenshire faced the challenge of aging pier infrastructure, putting the Net Pier, South Pier, and Fish Jetty structures at risk of failure. To address this issue, Aberdeenshire Council appointed TMS Maritime Ltd (TMS) as the Principal Contractor, relying on their extensive maritime expertise to develop innovative solutions that would ensure the long-term sustainability and safety of the harbour.

In the initial planning stages, TMS collaborated with DYWIDAG to identify the most suitable engineering solutions that would not only reinforce the existing structures but also minimize disruption to the local community and environment, particularly during the busy summer tourist season. Careful consideration was given to the project’s logistics, including the selection of appropriate equipment and methods for the installation of piles and other materials, to ensure minimal impact on the local community and meet the budget and timeline requirements.

The exposed coastal location presented a further challenge. Strong winds meant that the working window was constrained to the period between May and November, as the piers are frequently inundated with seawater outside these months. Therefore, close monitoring of weather forecasts and efficient use of calm periods were required to successfully complete the project without having to work into the winter period.

Solution

loader

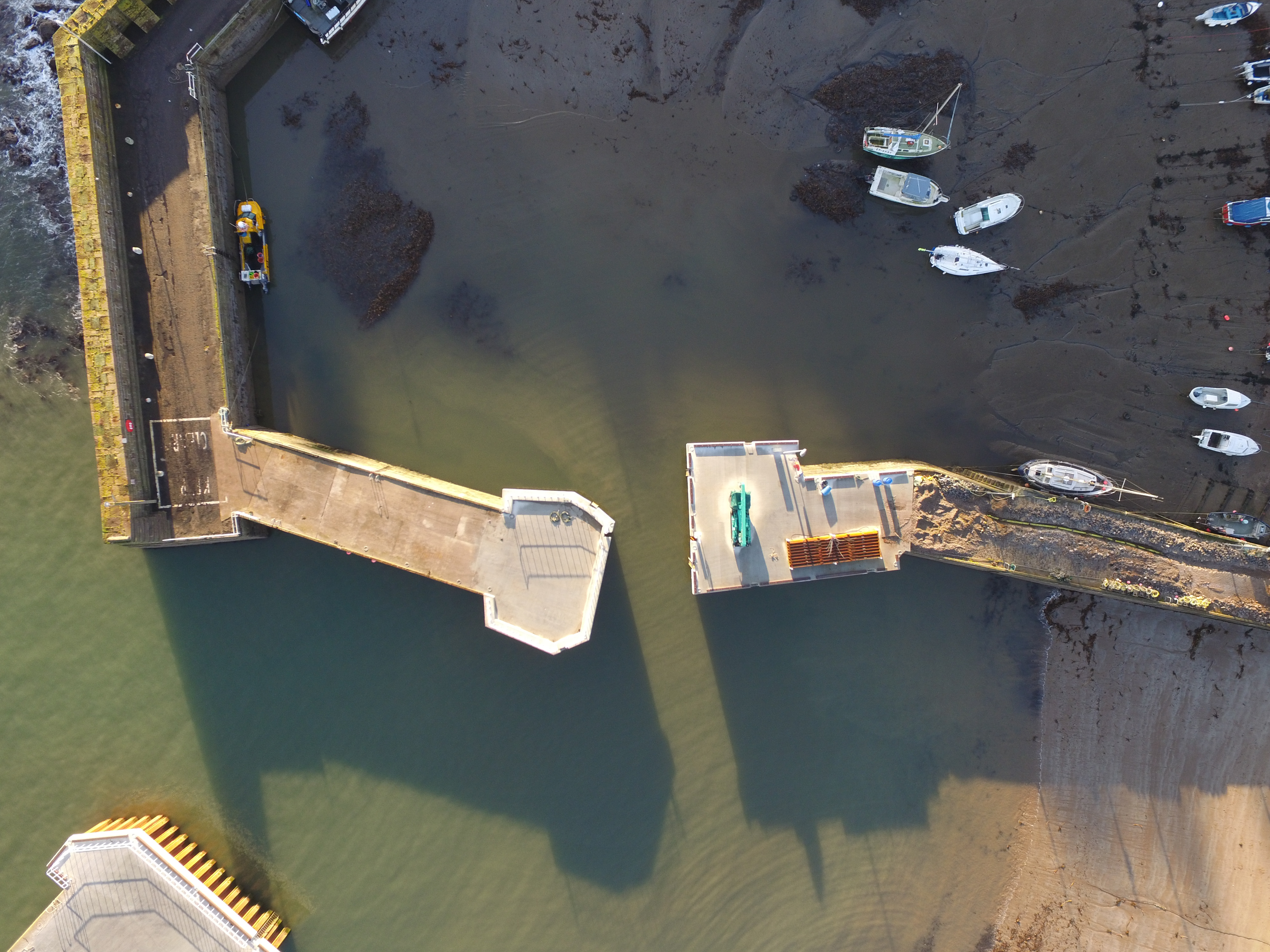

One of the key solutions employed in this project involved the installation of an interlocking steel sheet piled wall system on three sides of each pier, enclosing the existing piers. This approach provided robust support and protection to the aging structures. Through a thorough analysis of the site conditions, material requirements, and potential risks, TMS and DYWIDAG selected the DYWIDAG Marine Tie Rods to provide the necessary support for the new sheet piled quay wall system. These were used to support the berthing face retaining wall, ensuring the stability and resilience of the new quay wall.

50mm diameter Gewi Bars, varying in length, were utilized to provide six longitudinal tie rods, extending from ‘dead-man’ anchors at the existing old quay wall to terminate through the back walings of the new quay wall. These were then backfilled to form new pier substructures. The S355 grade gusseted angled plates, designed and manufactured by DYWIDAG, were installed by TMS to provide anchorage for the inner corner bracing ties, further reinforcing the newly constructed sheet piled quay wall. Additionally, a sacrificial anode cathodic protection system was designed and installed to further enhance the longevity of the sheet piles.

loader

The reconstruction of the piers required the demolition of the existing concrete decks and some masonry, including the underwater removal of a concrete cill structure between the South and Fish Jetties. Due to the age of and uncertainty over the existing piers’ structural integrity, vibration and tilt monitoring systems were set up to ensure there was no movement on the piers during the loading and piling works. These attached onto the existing piers during the works and were configured to alert the construction team if any movement occurred.

Reinforced concrete capping beams and slabs were constructed to provide a solid foundation for the new pier structures. TMS utilized a bolted cantilevered falsework system on the seaward side of the sheet piles, enabling the safe casting of the pier capping beams over the water. A new reinforced concrete pier deck, complete with ducts and access chambers, was cast to ensure the long-term functionality of the piers. Each pier was equipped with new handrails, mooring rings, and other essential furniture. The bottom brackets of the ladders, which were permanently submerged, were welded underwater by divers. Spare ducts were also included for future-proofing the piers.

loader

The project also involved the replacement of the existing boom gate system, which protects the inner harbour during storms. The old underwater concrete cill was removed and replaced with a new cill, guides, and boom gates, all fabricated and installed by the project team. The bottom cill was replaced with a permanent boom gate, welded in place by divers. Underwater welding was also required for the installation of the boom gate guides.

The project was an exemplar of innovative engineering and logistical planning, as TMS utilized Movax and impact hammer piling equipment, supported by cranes, to install the piles. Furthermore, a modular barge and tugboat were employed to transport most of the plant and equipment between the piers during the tourist season, minimizing disruption to local and tourist traffic. Finally, careful planning to take advantage of good weather ensured that TMS was able to complete the project ahead of schedule and under budget, without having to work into the winter months.

The successful collaboration between TMS and DYWIDAG on this project resulted in the revitalization of Stonehaven Harbour’s aging pier infrastructure ahead of schedule and under budget, whilst also ensuring the long-term safety, functionality, and sustainability of this essential maritime facility.
